This situation could have developed from e.g. one of the following actual progress curves: |
|
Situation I

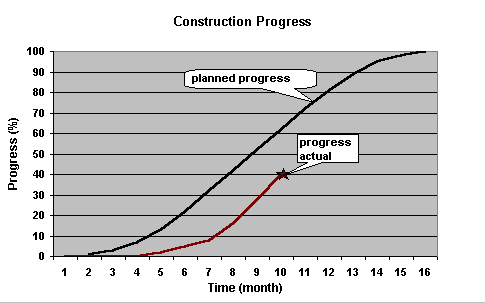

Contractor has started late and progress is less than planned. Possible reasons:
|
|
Situation II

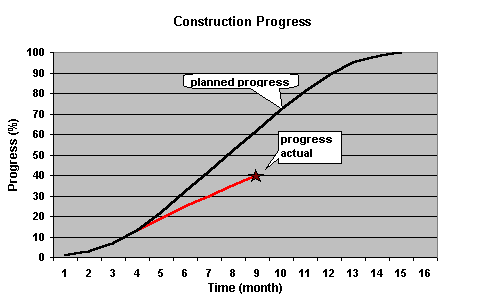

Contractor did start in time. Progress is falling behind. Possible reasons:
|
|
Situation III

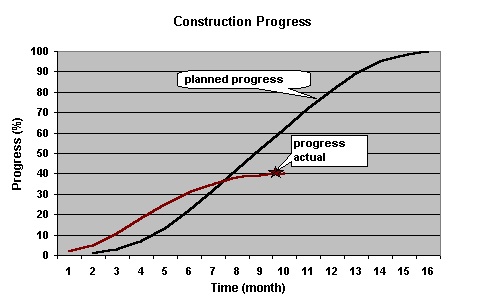

Contractor has started late but progress is picking up. Situation at this moment looks o.k. |
|
Situation IV

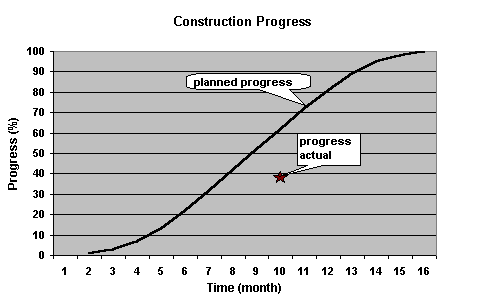

Contractor did start early. Progress now is tending to sero. Possible reasons: If there are no financial problems of client this could indicate company problems of subcontractor. To minimize delay of mechanical completion, possibly contracts discussion have to be started again. Situation most critical. |
